Fully Automatic Brooding Cage for Layer Hens: A Buyer’s Guide

News & Blog

Check out our latest news,

22
2026.08

Fully Automatic Brooding Cage for Layer Hens: A Buyer’s Guide

09:57

A fully automatic layer brooder cage is a multi-tier rearing system built for chicks from day one to transfer, with automated feed, water, manure removal and climate control sized to birds weighing under 1.3 kg. It is specified separately from production cages because feeder height, mesh spacing and heating loads differ.
Most equipment catalogues treat the brooder cage as a line item under the layer range. That framing costs money later. A pullet that arrives at the production house 100 g under target weight, or from a flock with a body-weight coefficient of variation above 10%, does not recover its lost laying persistency, and no amount of production-house automation fixes it.

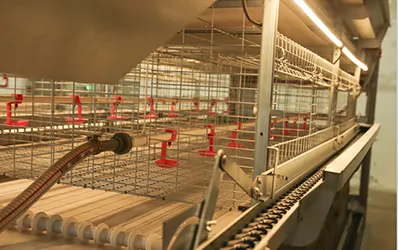

Fully Automatic Layer Brooder Cages

Why rearing and production cages are not the same machine

The two systems share a family resemblance and almost nothing else in their working dimensions.
A day-old chick weighs roughly 35–40 g and cannot reach a trough designed for a 1.8 kg hen. It falls through mesh spacing that safely supports an adult bird. It cannot regulate its own body temperature for the first two weeks, which makes the brooding house a heating problem before it is a ventilation problem. By week 16 the same bird needs perch and feeder access close to what she will find in the production house, or the transfer becomes a feeding disruption on top of a handling stress.
That is the design brief for a rearing cage: one enclosure that works for a bird whose body weight increases roughly 35-fold across the period it occupies the cage.

Manufacturers solve it with adjustable feed trough height, removable chick-guard mesh or a floor insert for the first weeks, and drinker lines on adjustable risers.

Design dimension Rearing / brooding stage Production stage
Hens weight served ~35 g at placement to 1.2–1.5 kg at transfer 1.6–2.0 kg, stable
Floor mesh Fine spacing plus chick mat or insert for weeks 0–2 Sloped egg-roll floor, adult mesh
Feed trough height Adjustable across the cycle Fixed at one bird height
Drinker line Adjustable height nipple line, low flow at placement Fixed height nipple line
Primary climate load Supplemental heat, 33–35 °C at chick level in week 1 Heat removal and air speed
Egg handling None Belt collection, central egg conveyor
Occupancy ~16–18 weeks per batch ~60–80 weeks per batch

Hens weights and brooding temperatures shown here are general planning references drawn from commercial layer strain management guides. Confirm them against the specific management manual for the strain you place, because targets differ between Hy-Line, Lohmann and ISA lines and are revised periodically.

Stocking density: the number that decides everything else

Density is where under-equipped brooding does most of its damage, and it is also the parameter competitor pages most often omit.
Two mistakes recur. The first is planning density on final bird count rather than placement count, which ignores the fact that the same cage tier must hold chicks at week 1 and near-mature pullets at week 16. The second is planning on floor area alone while ignoring linear feeder space per bird, which is the constraint that actually drives uniformity.

Work the calculation in this order:

  1. Fix the placement number, including the mortality and culling allowance you intend to carry (a 3–5% total loss allowance across rearing is a common planning figure; use your own farm’s historical rate if you have one).
  2. Take the strain manual’s cm²/bird figure for the final week before transfer, not the average across the cycle. That is your binding constraint.
  3. Cross-check linear feeder space per bird at the same final week. If the cage meets the area figure but not the feeder figure, uniformity will spread regardless of area.
  4. Confirm drinker-to-bird ratio at the same week, and check the nipple flow rate at the far end of the longest line rather than at the header.
  5. Divide by usable tier area, not gross cage footprint. Partition posts, feed hoppers and end frames consume area that the catalogue drawing may include.
  6. Only then choose tier count, and re-check that the top tier remains reachable for inspection without a platform your staff will not actually use.

Fully Automatic Layer Brooder Cages

What “fully automatic” actually includes at the brooding stage

The term covers different scopes across suppliers. At minimum, ask which of the following are in the quoted price and which are separate:

  • Feeding: travelling hopper or chain-and-auger, with the trough height adjustment mechanism specified rather than assumed
  • Drinking: nipple line with pressure regulator, plus water medication dosing point if you vaccinate through water
  • Manure removal: belt system with belt width, drive spacing and scraper type stated
  • Climate control: heating source, inlet type, fan capacity and the control logic — whether static setpoint or curve-based by bird age
  • Lighting: dimmable and programmable, since the rearing light programme is a management tool rather than illumination
  • Chick-stage inserts: floor mats, guard mesh, extra chick drinkers for week 1
  • Weighing: automatic bird weighing platforms, usually quoted separately

Compared with general-purpose cage systems sold as an accessory to a layer range, a purpose-built rearing system is judged mainly on the adjustability of feed and water height and on the control curve for heating during the first fortnight. Those two items separate systems that look similar in a catalogue photograph.
FAO poultry production guidance identifies early-stage brooding management as a principal determinant of subsequent flock performance in commercial systems. Source currency should be verified before this reference is republished.

Fully Automatic Layer Brooder Cages

Transfer timing and what constrains it

Transfer usually falls between weeks 15 and 17 for commercial layers, and the equipment on both ends constrains the window.
Transfer too early and pullets enter the production cage before they can reach a fixed-height trough, which produces a feed-intake dip during the exact period when body weight should be climbing towards onset of lay. Transfer too late and birds may come into lay in the rearing cage, where there is no egg collection and eggs are lost or broken on the mesh.

Three equipment facts determine your real window:

  • Feed trough height in the production cage, measured against pullet body height at the planned transfer week
  • Perch or platform availability in the rearing cage during the final weeks, which affects how quickly birds adapt to the production cage layout
  • House-to-house transfer distance and the crate handling method, since time off feed and water during transfer is itself a uniformity event

An edge case worth planning for: farms running continuous placement with a single rearing house. If your rearing cycle is 17 weeks and your cleaning and downtime is two weeks, one rearing house cannot serve a production house on a rolling schedule without either a second rearing house or accepting a gap in production placement. Check this before ordering, not after.

Mugong Fully Automatic Layer Brooder Cages: published specification status

The site lists this product as a cascade rearing system for raising layer chicks in cages with a corrosion-resistant structure. Detailed dimensional parameters are not published. Rather than substituting figures from a different product line or from another manufacturer, here is what is confirmed and what a buyer must request.

Parameter Status Notes
System type Published Cascade (stepped) rearing system for layer chicks
Structure and corrosion protection Published Corrosion-resistant structure; company product line uses hot-dip galvanized and aluminized-zinc materials, with aluminized-zinc stated at 3–4× the corrosion resistance of ordinary hot-dip galvanized wire and validated by 500+ hour salt-spray testing
Certification Published Company-level ISO 9001:2015, CE and SGS. No model-specific certificate number is published

The production-cage column is included for one reason: house planning. If the rearing and production houses sit on the same site, the aisle width and column spacing of the production system usually set the site layout, and the rearing house is fitted around it.

Fully Automatic Layer Brooder Cages

Specification request list to send with your enquiry

Send this as a written list rather than asking for a general quotation. It shortens the quotation cycle and makes competing offers comparable.

  1. Tier count options available, and the total system height for each
  2. Cage unit internal dimensions and usable tier area per unit
  3. Manufacturer’s stated stocking density at week 16, in birds per cage unit and cm² per bird
  4. Linear feed trough length per cage unit and resulting cm per bird at the density above
  5. Nipple count per cage unit and the stated bird-to-nipple ratio
  6. Feed trough and drinker line height adjustment ranges, in millimetres
  7. Chick-stage components included: floor mat or insert type, guard mesh, supplementary chick drinkers
  8. Manure belt width, drive configuration and cleaning interval assumed in the design
  9. Heating equipment scope: whether supplied, and the design temperature curve by bird week
  10. Ventilation design basis: air volume per bird at week 16 and at design ambient temperature for your site
  11. Aisle width and minimum house internal width required
  12. Compatibility statement with the production cage system you intend to use, if it is from the same supplier
  13. Material specification per component: which parts are aluminized-zinc, which are hot-dip galvanized, which are painted steel
  14. Installation scope: equipment only, supervised installation, or full turnkey

What this costs, and what the published ranges do and do not cover

Mugong pricing is quote-based and project-specific. No published price range exists for the rearing system, so any figure for brooding equipment must come from a quotation rather than from a catalogue.
What can be published are market-reference ranges for layer production equipment, which help a buyer self-qualify before enquiring:

Project Type Estimated Cost Notes
Automatic layer battery cage, equipment only ~US$15–25 per bird capacity Industry norm for H-type and A-type systems, per Vpoultryfarmequipment
10,000-bird layer cage project, equipment ~US$18,000–32,000 Varies by automation depth and steel specification, per Poultryfarmbusinessplan
20,000-layer fully automatic system ~US$35,000–120,000 Varies by automation configuration level, per Tpoultryfarmequipment
Full turnkey (cage, house and site works) Quote only Building, ventilation and site preparation add large variable cost

Two cautions on reading those numbers. Per-bird figures and total equipment figures are not interchangeable, and a per-bird figure quoted with housing included is a different number from one quoting cage equipment alone. The ranges above are for production cages; rearing equipment for the same flock is an additional line, not a share of the same budget.
Cost drivers to raise in the quotation conversation: bird capacity and tier count, manual versus semi-automatic versus fully automatic specification, galvanized versus aluminized-zinc structure, depth of climate control, whether a steel-structure house is included, destination country freight and certification, and turnkey scope.

FAQ

Q: Can I rear pullets in the same H-type cage I use for production?

A: Physically the birds will fit from around week 8, but not before. The binding problems are trough height, mesh spacing and the absence of supplemental heating in a production house. Some operators run a modified production cage as a grower cage from week 7 to transfer, with a separate week 0–6 brooding system. That two-stage approach adds one handling event, which is a trade-off against the capital saved.

Q: What tier count should I choose for a rearing house?

A: Tier count follows density and inspection access, not the other way round. Higher tier counts reduce house footprint per bird but make top-tier inspection and manual culling slower, and staff who cannot easily see the top tier will not check it as often. Request the supplier’s stated density per tier and calculate house length both ways before deciding.

Q: How long is the rearing cycle, and how does it affect house scheduling?

A: Commonly 16–17 weeks to transfer, plus cleaning and downtime between batches. That total determines whether one rearing house can serve one production house continuously. Work the schedule out on a calendar before sizing the rearing house.

Q: Are Mugong brooder cage dimensions available?

A: Dimensional parameters for the rearing system are not published. Send the specification request list above with your enquiry and the engineering team will return the figures for the tier configuration you are considering.

Q: Does the rearing system have to come from the same supplier as the production cages?

A: It does not, but sourcing both from one supplier makes house layout, aisle width and control-system integration a single design problem rather than a negotiation between two vendors. If you split the order, ask each supplier for a written compatibility statement covering aisle width, house internal width and controller protocol.
